Last updated: July 7, 2026 ยท Prices reviewed quarterly

Drying a home takes 3 to 5 days in typical cases — but “restoration” includes rebuild, so the honest full answer is days for minor events, 1-2 weeks for average jobs, and 2-6 weeks when demolition and reconstruction are involved.

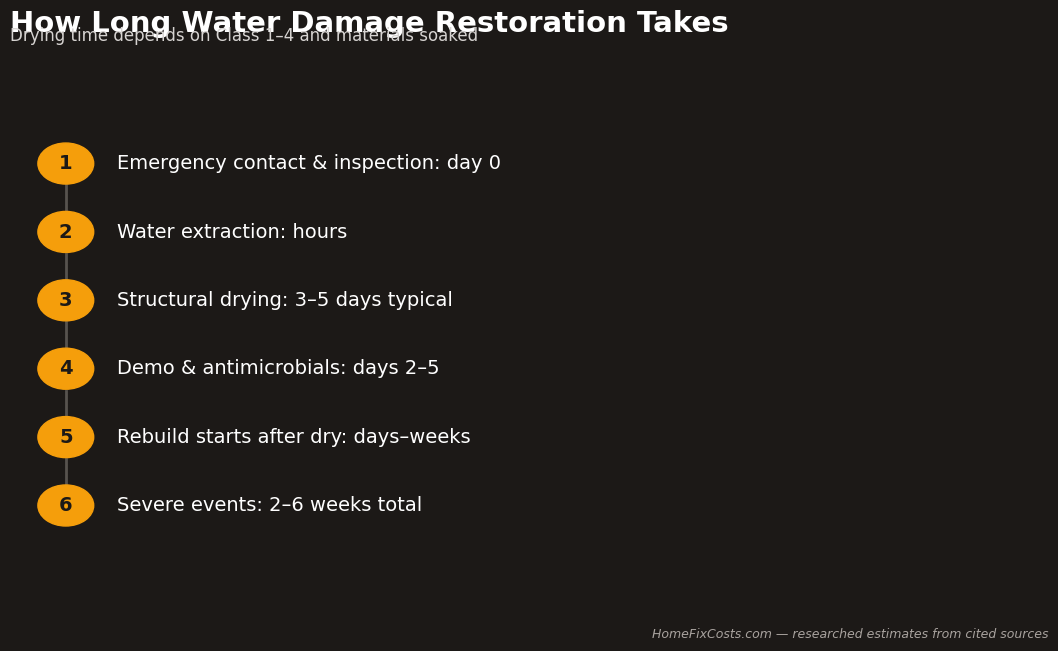

How long water damage restoration takes, stage by stage

The timeline, stage by stage

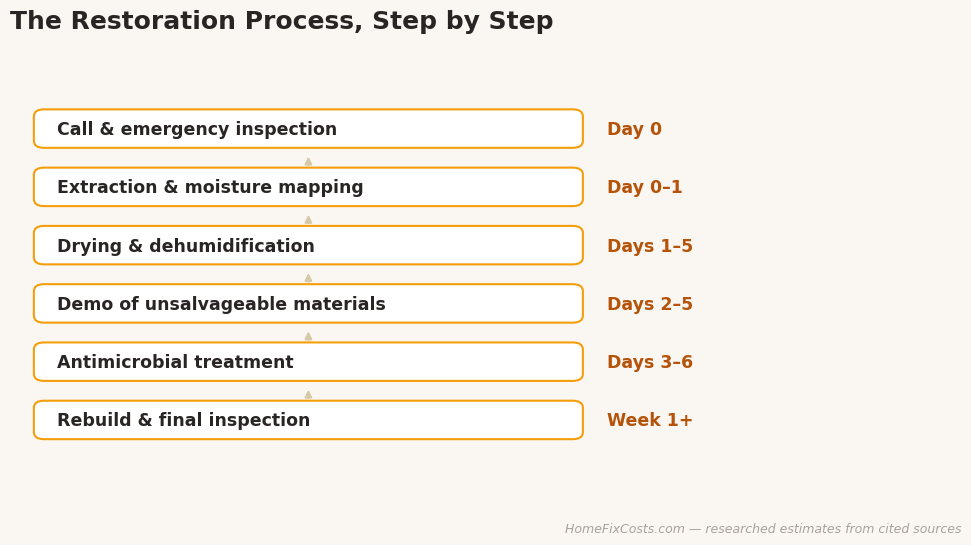

Water damage restoration process from call to rebuild
StageTypical durationNotes
Emergency response & inspectionSame dayMoisture mapping sets the plan
Water extraction2 – 8 hoursStanding water out fast
Structural drying3 – 5 daysAir movers + dehumidifiers, daily readings
Demo & antimicrobialDays 2 – 5 (overlaps)Only unsalvageable materials
Reconstruction3 days – 4+ weeksDrywall, floors, paint — scope-dependent

What stretches the clock

Water class: Class 3-4 events (saturated walls, hardwood, concrete) dry slowest. Category: Category 3 adds demo and disposal before drying even finishes (categories explained). Insurance approvals: rebuild often waits on adjuster sign-off — push scope agreement early (insurance guide). Hidden moisture: cavities that never got metered come back as mold weeks later (and cost real money).

The two mistakes that add weeks

Turning equipment off at night (“too loud”) restarts drying daily — equipment runs 24/7 or the readings lie. And skipping verification: never let a contractor pull equipment without showing final moisture readings at or below the dry standard for your materials.

Can you live at home during it?

Category 1-2 with localized drying: usually yes — noisy but livable. Category 3, or drying that takes out the kitchen or only bathroom: plan to relocate, and note many policies pay Additional Living Expenses (ALE) when a covered loss makes the home uninhabitable. Ask the adjuster about ALE explicitly.

Official resources & free help

FAQ

Four days of fans and the walls still read wet.

Ask for the drying log: readings should fall daily. Flat readings mean hidden saturation (insulation, sill plates) — better to open the cavity now than grow mold behind fresh paint.

How fast does mold start?

Growth can begin in 24-48 hours on damp porous materials — extraction the same day matters more than any other cost decision. See the cost guide.

The contractor wants to demo everything immediately.

For Category 3, aggressive demo is correct. For Category 1-2, drying in place is often possible — ask what the moisture map says before signing a big demo scope.

Prices on this page are researched estimates compiled from the cited sources; your local costs will vary with market, access and scope. Always get multiple written quotes from licensed professionals before hiring.
